PS-SPS Users Meeting for Week 18 held on May 2nd, 2024

May 2nd: The meeting will start exceptionally at 10:45 (for availability of the conference room).
May 8th : Exceptionally meeting on WEDNESDAY 10h30 on ZOOM only (chaired by M.J.) due to CERN holiday on Thursday.
June 13th: User meeting exceptionally on zoom only (for availability of the conference room).

The agenda for this meeting is based upon user schedule v1.0.2, please cf. here.

News from the PS & SPS Physics Coordinator (E.B. Holzer, M. Jaekel)

Proton Run 2024

Ion Run 2024

Reminder: All beam time exceeding the limits of 2 weeks PS beam time and 1 week SPS beam time (added proton and ion beam time!) per year need the approval of one of these CERN committees: SPSC, LHCC, DRDC, INTC, RB or IEFC. Consider joining a DRD collaboration, if you require more beam time.

News from the Facilities Operations Meeting (FOM) (EB Holzer)

This week MDs - Week 18:

Upcomming MDs:
Week 19: Wednesday dedicated SPS MD --> access to ECN3 possible
Week 20: no dedicated MDs (because of LHC MDs)
Week 21: Dedicated SPS MD 22/5 (crystal shadowing) with beam extracted to North Area --> no access to ECN3
Week 22: Dedicated SPS MD 29/5 (COLDEX, no extraction to TT20) --> access to ECN3 possible

If any facility wishes to continue operation past December 2, then please,
send by email the request to fom-support@cern.ch with…
➢ Dates
➢ Short justification
➢ Operation mode
➢ Regular, i.e., requiring all the sub-systems
➢ Limited, then please specify which equipment and subsystems are needed

Deadline: May 14

PS Machine Report (Ewen Maclean)

SPS Machine Report (M. Schenk)

Safety (A. Schouten)

nToF (M.Bacak and P.M.Milazzo)

Stable data taking and few interventions during the week:

East Area Beam Status (B. Raë)

No major issues. Small issue on Monday night on the Beam stopper that didn’t affect the beam availability.

On call number: 67500

T09: Normal operation. Low momentum configuration was done on 30th April for PAN. Next week for Straw the low-pressure threshold cherenkov and the XBPFs and XSCIs will be put back keeping the high-p XCET un-installed to reduce the material for their low momentum beam.
T10: Good operation.
T11: No operation/no user.

East Area Users Tour de Table

T8 Main: IRRAD/CHARM (F. Ravotti / S. Fiore)

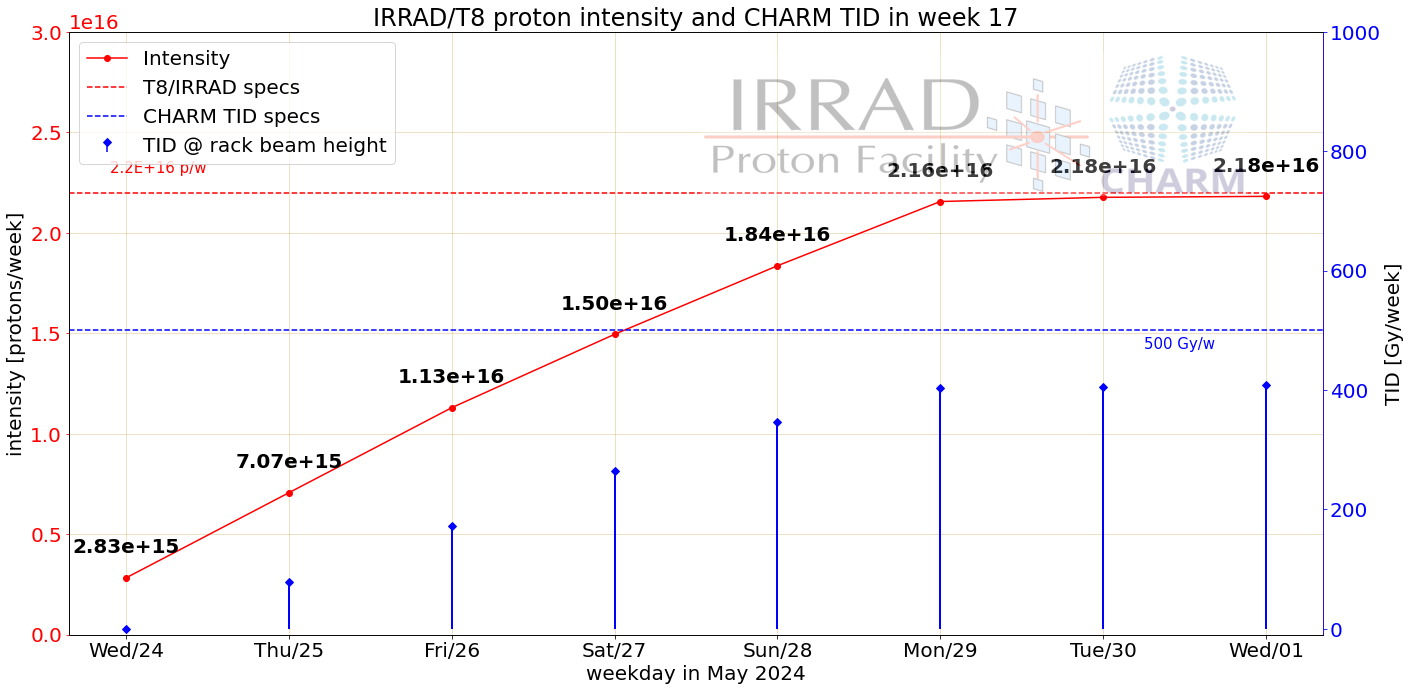

Regular user operation. Good week, cumulated ~2.2e16 p/w on T8, see plot below. Problem with beam trajectory on Thursday morning ~6:45 due to issues with the T8 stabilizer tool being commissioned since the day before.

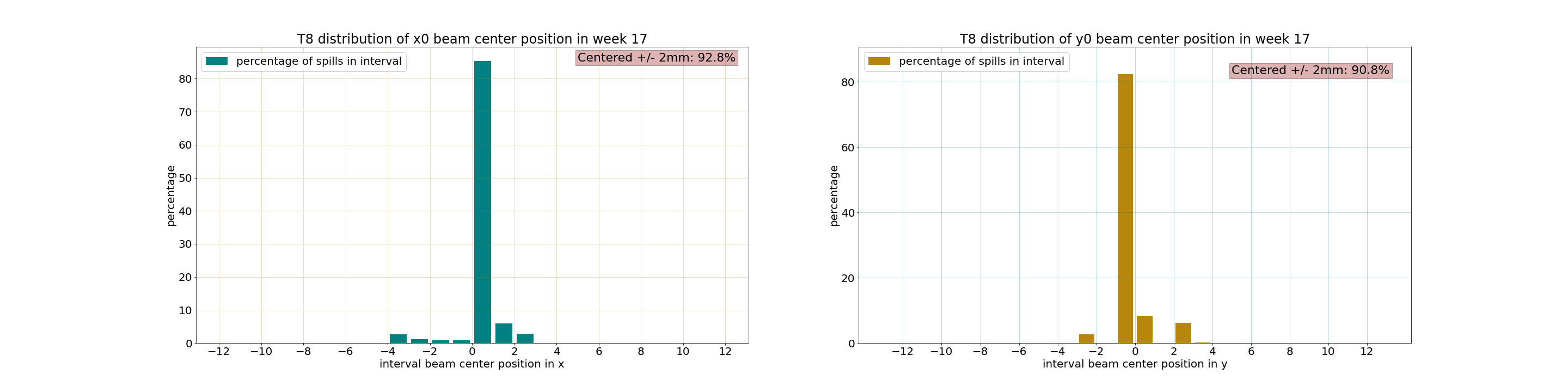

Despite the issue, good beam steering during week 17 (center within +/- 2mm >90% of the time on both axis):

Beam stop on Monday night to be able to access on Tuesday (holiday on Wednesday) in parallel with EA1 access at lunch time. About Tuesday access: in IRRAD, exchanged the dosimetry for the ongoing experiments and added complex on-line experiment for TE-CRG (see pictures below). For CHARM, >400 Gy delivered at the reference dosimeter during last week. Fast access to change daughterboards on BE-CEM-EPR new test setup, with no movement of rack. Good planning and design of the setup allowed to finish with 1/20 of the average dose to personnel. Beam back in the afternoon around 4pm with reduced intensity as requested by the TE-CRG experiment. Nominal intensity from Wed. around 10am. We continue running until next week on Wednesday.

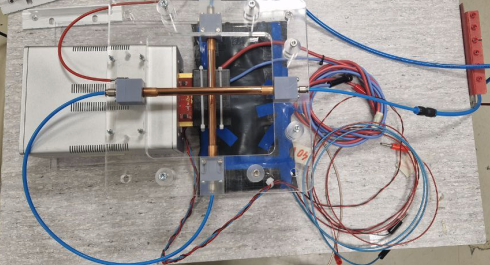

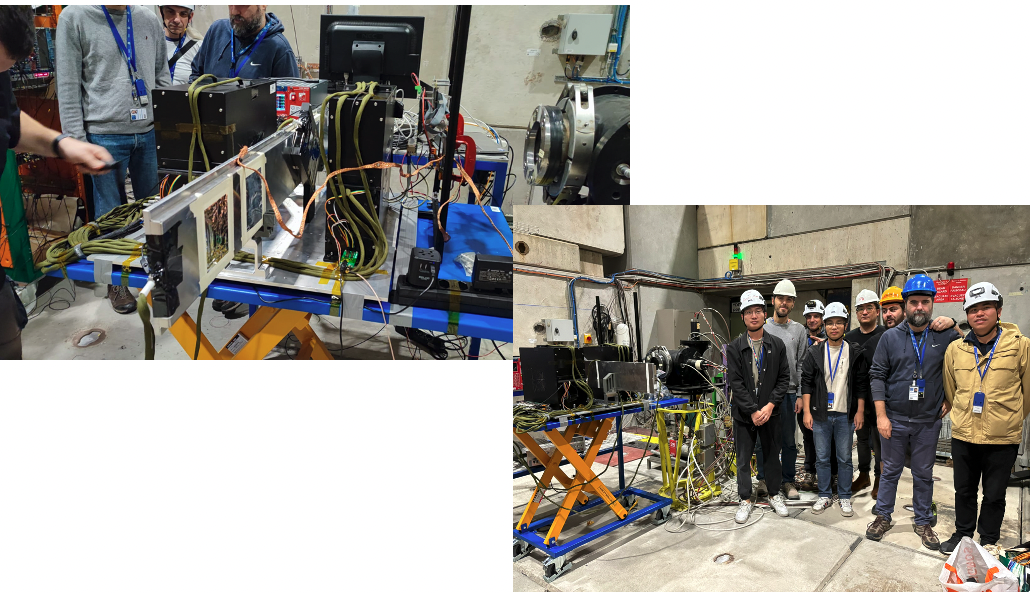

**TE-CRG experiment in IRRAD: **

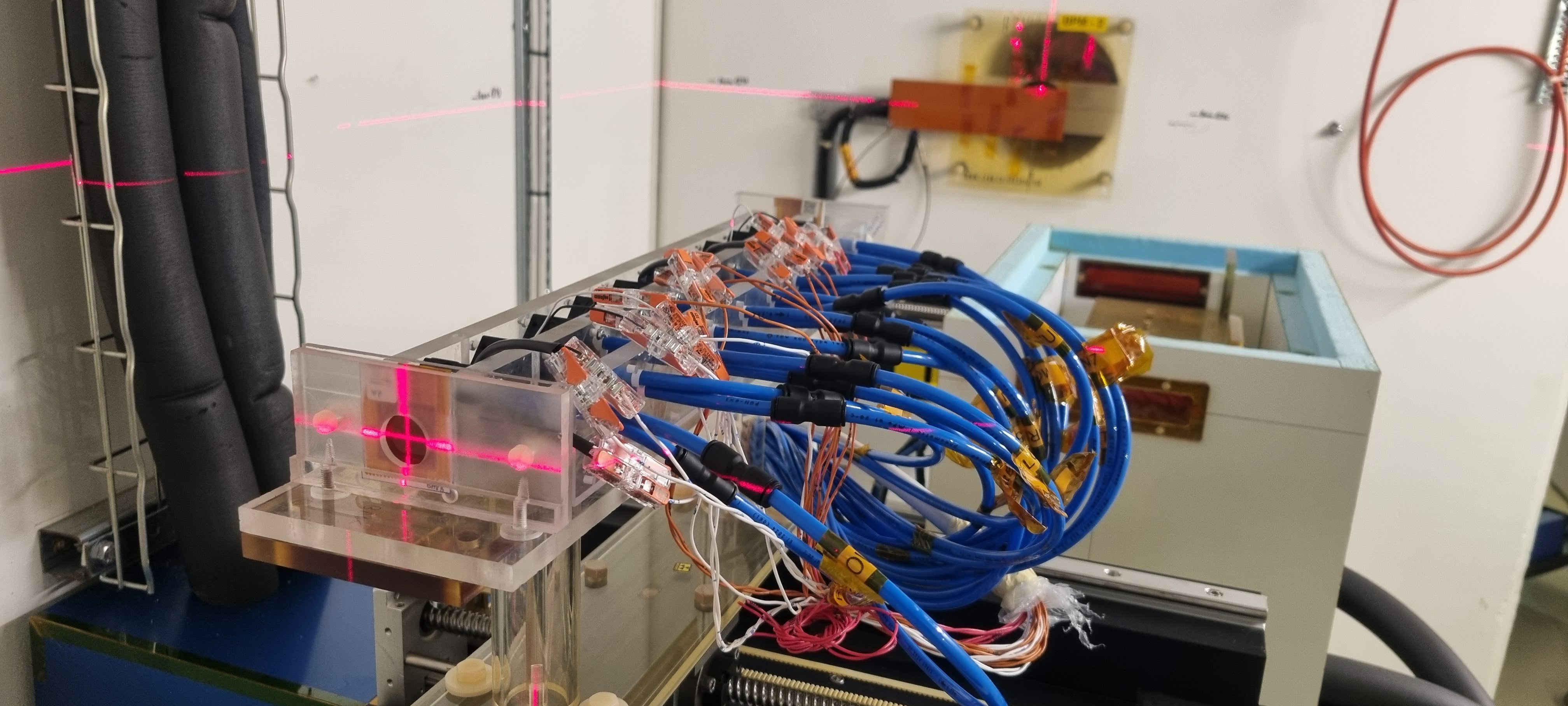

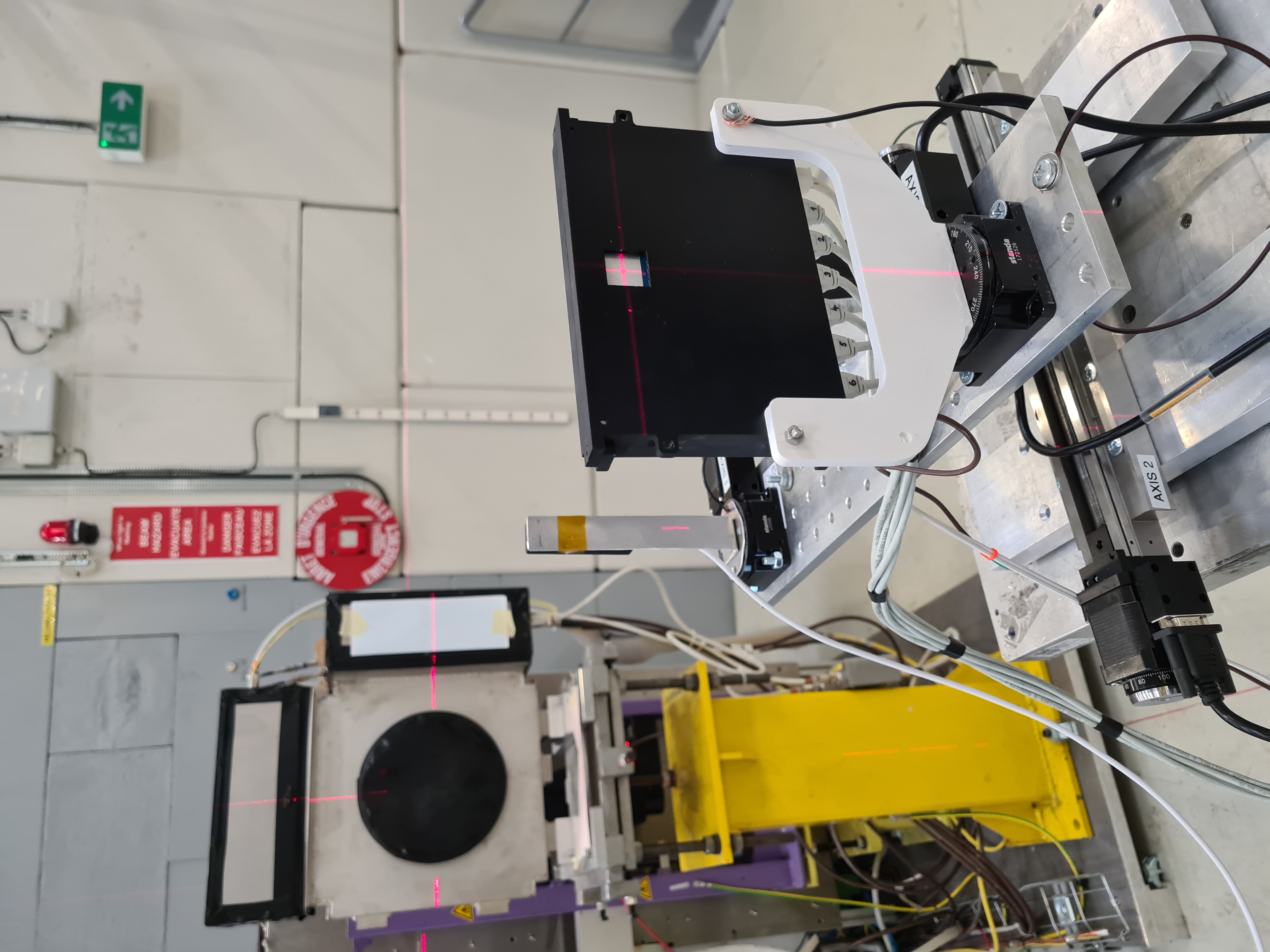

**Control unit in IRRAD technical area: **

T9 Main: PAN (Johannes Hulsman)

MiniPAN
MiniPAN was placed and set up on Wednesday afternoon and Thursday morning. We passed safety on April 25th. However, we only started taking data on Friday as one of the readout boards was faulty and needed to be replaced.
On April 29 the readout was replaced by a better one.

PixPAN
The PixPAN sensor we are testing has been mostly operating without issues. Valueable data was collected.

Scint. and Cherenkov Detectors
Tuesday, 30th of April, the instrumention for the scintillators and cherenkov detectors were removed. A vaccuum pipe was placed instead. This is in agreement with the discussion we had before to improve the beam quality for the second week.

Beam Configurations
So far: 0.1, 0.5GeV, 1GeV, 2GeV hadrons
Planned this week: 0.1GeV, 0.15GeV, 0.2GeV, 0.3GeV, 1GeV, 5GeV electrons

T9 Incoming Main: STRAW TRACKER RD (Week 19) (Temur Enik, Katerina Kuznetsova)

T10 Outgoing Main: ALICE TIMING (Sofia Strazzi)

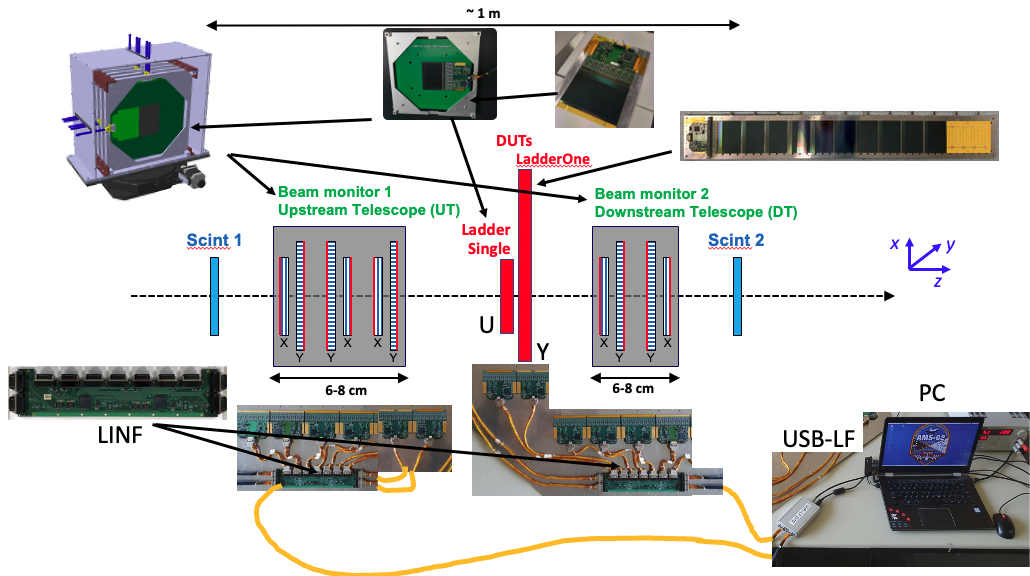

T10 Main: MEDIPIX (Benedikt Bergmann)

We have taken over the beam on Tuesday from Alice Timing. Safety visit was done on Tuesday at 17:00. Patrol training done, not sure if we have gotten the patrol right just yet.

Measurements have started around 18:00. We have been running with hadrons positive polarity 10 GeV/c momentum for the entire day yesterday without problems.

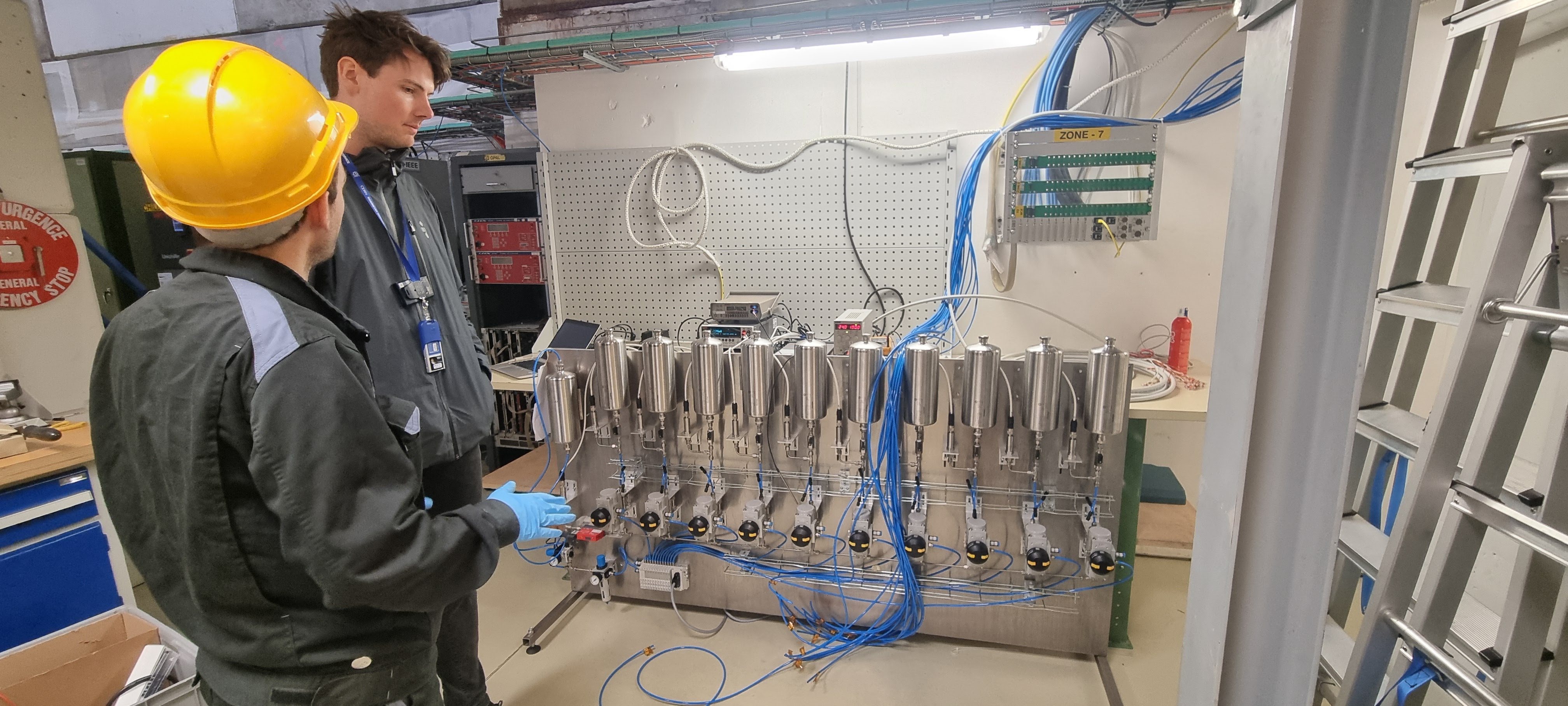

Picture of the setup:

Measurements done

Next measurement @ 10 GeV/c momentum:

Momentum change to 3 GeV/c foreseen for Monday - if everything goes according to the plan.

T10 Incoming Parallel: ALICE FOCAL (Week 19) (Please Put Your Name Here)

T10 Incoming Main: ALICE ITS3 (Week 19) (Paolo Martinengo)

Preparing to install as scheduled
We may be interested in staying also in week 20

AWAKE (M. Bergamaschi)

Last week summary

Proton beam: On Monday good delivery from SPS, Tuesday -Friday few extractions because of issue with injectors and LHC fills, Saturday-Sunday good delivery

  M T W Th F S S
SPS extration 1278 378 MD 450 561 1083 1125
Hours of beam to AWAKE 9.5 3.1 MD 4.9 4.4 6.7 6.9

Detailed program of last week:

Next run starting the 20th of May

HiRadMat (N. Charitonidis)

HRMT-64 experiment advancing well, dedicated & parasitic teams taking beams. Many thanks to the flexibility by PSB/PS & SPS for extremely fast adaptation to the various beams requests (type, intensity & emittances)!

North Area Beam Status (B. Raë)

Proposed target sharing

Target Units (1e11) Comment
T2 100 NA64e
T4 40 T10/NA62 defines T4 intensity
T6 50
T10 20

Next change in week 21.

General: Smooth operation.

On call number: 67500

H2: Alice Phos installed and take Data. Good operation.
H4: Good operation, vacuum transformation for NA64e
H6: A few radiation warnings on Saturday night but these were safe and the intensity was reduced a little on Sunday. Otherwise, no issues. CERF changeover this morning - reminder: no downstream access this week even when beam off briefly.
H8: Good operation.
M2: No major issues.
P42/K12: Good operation. Routine re-steering to T10 done after transmission dropped slightly.

North Area Users Tour de Table

P42-K12:

Main: NA62 (Renato Fiorenza)

Some instabilities in both beam intensity and in beam oscillations, see attached slides. This morning the situation improved very much. Otherwise data taking is proceeding smoothly.

M2:

Main: AMBER (Thomas Poschl)

subsequent filing of minutes for last meeting (25/04/24):

H2:

Main: ALICE PHOS (Mikhail Ippolitov)

Transport, installation and safety clearance were done on 29.04. The detector was stabilized at T=+16.5. The beam line was prepared by noon on 30.04. Until 8-00 02.05 energy scans at +16.5 were finished and cooling started. We expect -25C at 03.05. late in the evening. The beam was very good. We took a lot of good data. As example, here very nice linearity curve(online data). Deviation 0.087@150 GeV.
,![](https://codimd.web.cern.ch/uploads/upload_c9fae7cde35437af9433d23c90800e 5b.JPG)

H4:

Main: NA64e (L. Molina Bueno)

We completed installation last Friday and we started commissioning a calibration this week. A brief presentation summarises the activities carried out

H6:

Outgoing Parallel: MONOLITH (Lorenzo Paolozzi)

Outgoing Main: EP PIXEL (Dominik Dannheim)

Main: CERF (Robert Froeschl, Fabio Pozzi, Marco Tisi)

Parallel: ATLAS MALTA (Anusree Vijay, Tomohiro Inada, Carlos Solans)

Incoming Main: ATLAS HGTD (Week 19) (Stefano Manzoni and Djamel Boumediene)

HGTD testbeam from 08/05 to 22/05 (then from 29/05 to 12/05)
Aim of the testbeam measurement of performance of module (LGADS+ASIC) and individual LGAD

Beam request: pions at ∼120 GeV, 1-2 cm2, intensity ∼10k particles/spill

H6A (PPE-146) material:

Expected installation and commissioning time about 1-1.5 day
ISIEC submitted today befor the meeting

Incoming Parallel: RE1 AMS L0 (Week 19) (INFN-Perugia: Matteo Duranti, matteo.duranti@infn.it, Gianluigi Silvestre)

Purpose: measure the spatial resolution (+ the efficiency under the bias resistor region) of the first flight models built for the upgrade (Layer 0, L0) of the AMS-02 experiment on the International Space Station

12 cm2) Si μ

Beam:

Setup:

Logistics (PPE 166):

Incoming Parallel: CMS MTD ETL (Week 19) (Giacomo Zecchinelli)

Incoming Parallel: ATLAS BCM PRIME (Week 19) (Please Put Your Name Here)

H8:

Main: LHCb (Please Put Your Name Here)

Parallel: LHCb SciFi (Federico Ronchetti)

Incoming Main: UA9 (Week 19) (F. Galluccio)

UA9 will start installing on Wednesday the 8th, as soon as the beam pipes will be removed.
This year we will run with 6-plane tracker and will have a timepix3 as extra beam monitor; this run will be mainly dedicated to the commissioning of the detector in the new configuration.
I will contact M. Lazzaroni to specify which beam pipes to open and to know at what time we can start installing.
ISIEC is being submitted.
Still big conflict (UA9 and MUONE at the same time) in Autumn draft plan.

Parasitic Users

H8: STRAW TRACKER RD (Temur Enik, Katerina Kuznetsova)

H8: CMS PPS (F. Garcia)

The setup has been installed and consists of three platforms: The Rerence tracker, the psQ together with the Q-Fib and the trigger together with the irradiated Diamond box.

All the connections and installation has been carried out in a series of access agreed with the SciFi group with whom we share the same experimental area.

For the time being being we are waiting for the Safety inspection today around 15:30 then afer we will start to alignment of the detectors. The ISIEC was submitted on last Monday and I am waitinf for confirmation.

So far the beam conditions are not the best, but to have some coarse calibration is fine, however for data taken most probable no. The issue is the beam spot which is has very large dispersion in the vertical plane.

We expect that once the system is ready for taking data then we start to negotiate some shifts for data taken.

Everythig is working fine and no major issues to report has been encountered. Many thanks to all the teams of the NA for your support and also for the teams in the H8 line for their cooperation.

H8 Incoming: LHCB (Week 19)

AoB
